This explanation is written for US aerospace OEMs, suppliers, quality engineers, and AS9100D practitioners who need to apply this correctly, not just recognize the acronym. In an industry where a single escaped defect can affect multiple lots, programs, or operators, disciplined problem-solving isn't optional paperwork. It's risk management.
Many quality teams can fill out an 8D template without actually proving a root cause. This article breaks down what AS13000 requires, how it connects to the eight-discipline method, the D0–D8 flow, and where the approach does (and doesn't) apply.
Key Takeaways
- AS13000 defines aerospace customer requirements for using 8D; it doesn't invent a separate methodology.
- 8D supplies the structural disciplines, while contracts and customer portals often add specific forms, timelines, and escalation rules.
- A completed 8D report proves nothing on its own; verified root cause and effectiveness evidence are what matter.
- Apply AS13000 proportionately, alongside your AS9100D corrective-action process, not as its replacement.

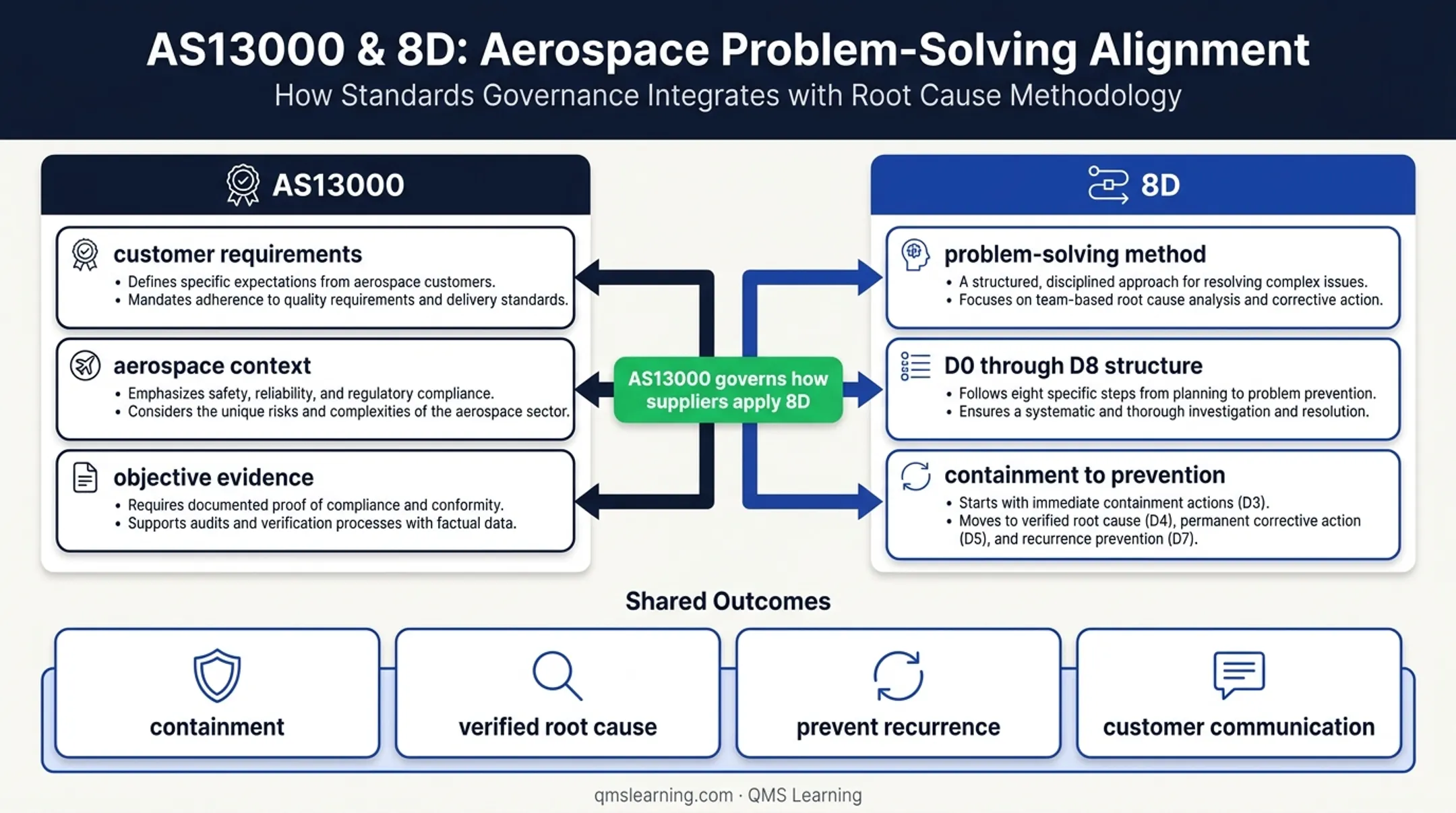

What Is AS13000 and How Does It Relate to 8D?
AS13000, titled Problem Solving Requirements for Suppliers, is published by SAE International's G-22 Aerospace Engine Supplier Quality committee.
Its current revision, AS13000A, defines customer requirements for supplier use of the Eight Disciplines (8D) method when responding to a corrective action request, according to SAE's AS13000A standard.
That distinction matters: 8D is the method, and AS13000 is the aerospace-context requirement for applying it. The standard is designed to drive:

- Containment of the immediate issue
- Verified root causes, not assumed ones
- Elimination of recurrence through tested corrective action
- Objective evidence communicated to the customer or stakeholder
AS13000 is often mentioned alongside other quality tools, but none substitutes for it:
- 5 Whys and fishbone analysis support root-cause identification inside D4; they don't constitute a full response.
- FMEA is prospective risk analysis. It doesn't establish what actually caused a failure that already happened.
- CAPA and AS9100D corrective action cover the broader management-system obligation; AS13000-style 8D can feed evidence into that process.
Before you standardize an internal workflow, confirm the applicable revision, customer-specific forms, reporting timelines, and escalation rules. Rolls-Royce, Collins Aerospace, and Pratt & Whitney each invoke problem-solving requirements differently, so a one-size-fits-all procedure can miss contractual details.
Why AS13000 Is Used in Aerospace
Aerospace supply chains run deep: an OEM might rely on dozens of tiered suppliers and special-process providers for a single component. When a defect surfaces, it rarely sits in isolation. It can touch multiple lots, programs, or downstream customers before anyone notices the pattern.
A few aerospace realities explain why a consistent method matters more here than in many other industries:
- Long product lifecycles mean a latent defect can resurface years after production.
- Configuration control and traceability requirements demand that root-cause work tie back to specific lots, serials, and drawings.
- Low-volume, high-complexity production limits the statistical cushion that higher-volume industries use to absorb variation.
- Regulatory oversight and customer audits expect documented, defensible evidence, not verbal assurances.
Customer requirements reflect this. Collins Aerospace's supplier quality requirements permit 8D "or equivalent," but they also mandate independent over-inspection across at least three consecutive manufactured lots after corrective action, according to Collins Aerospace's requirements.
Method flexibility doesn't remove the obligation to prove the fix worked.
Without a disciplined method, the common failure patterns look like this:
- Vague problem statements that can't be traced to specific parts or processes
- Fixing the symptom (rework the bad part) instead of the cause
- Treating a suspected cause as a verified one
- Containment that never gets elevated to a permanent correction
- The same nonconformity reappearing on next year's audit
Is AS13000 universally mandatory? No. It's a published standard, but individual OEMs decide whether and how to invoke it. Rolls-Royce adopted it directly into supplier notices; other customers reference it through RM13000 guidance or accept an "equivalent" method.
Always check your specific contract language rather than assuming a blanket requirement.

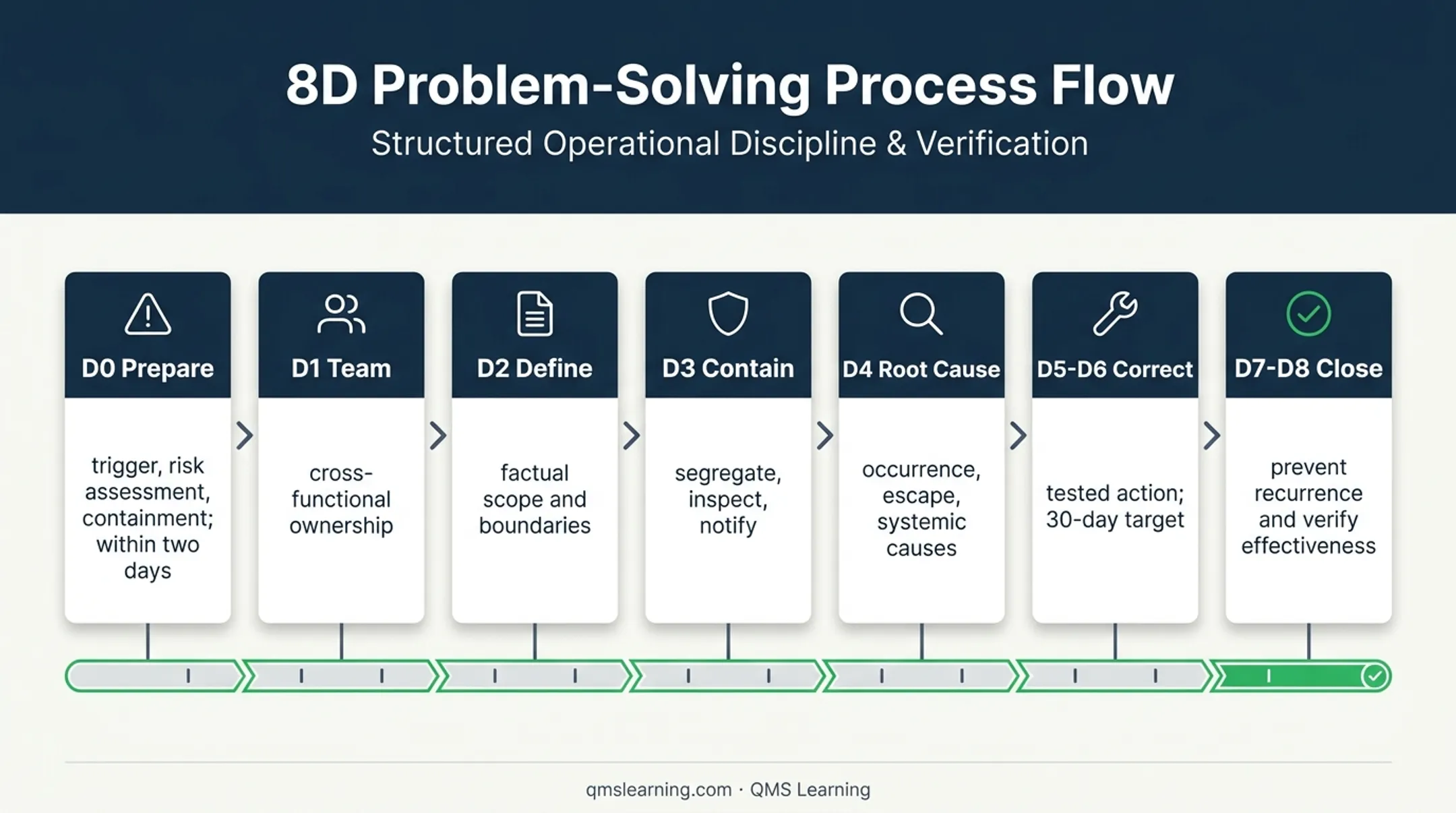

How AS13000/8D Works: The Conceptual Flow
The underlying logic runs from recognition through closure: spot and prioritize the problem, assemble the right people, define the condition precisely, contain the risk, find and verify the cause, fix it permanently, prevent recurrence, and close with documented evidence. AS13000A labels this D0 through D8.
D0: Prepare and Plan
D0 covers the trigger (a customer complaint, a rejected lot, an internal escape), an initial risk assessment, and immediate containment before the formal team even convenes.
AS13000A requires D0 to be completed within two days of problem identification, unless otherwise agreed, according to SAE's AS13000A standard. This step distinguishes immediate risk control from the permanent fix that comes later.
D1: Establish the Team
The team needs cross-functional knowledge: the process owner, engineering, manufacturing, quality, and in many cases the supplier or customer. Record who owns what decision. A team without clear ownership tends to produce reports nobody can defend later.
D2: Define the Problem
This step requires a factual, evidence-based statement: what happened, where, when, how extensive it is, and what boundaries are known. "Bore diameter measured out-of-tolerance on three lots from Supplier X, detected at incoming inspection on [date]" is usable. "Dimensional issue" is not. Vague problem statements make root-cause analysis almost impossible to verify later.
D3: Implement Interim Containment
Containment might mean segregating suspect stock, a stop-ship decision, 100% inspection, or customer notification. One real example: an out-of-tolerance bore found across three lots led to containing all suspect stock while the investigation proceeded. Containment reduces exposure. It does not remove the root cause.
D4: Identify and Verify Root Cause
This is where most 8D reports fall apart. Teams need to distinguish:
- Occurrence (generation) cause: why the defect was created
- Escape cause: why it wasn't caught before shipment
- Systemic cause: what quality-system gap allowed both
Tools like 5 Whys, fishbone diagrams, and process data review support this step, but a cause only counts once it's verified, not just theorized. A few good parts right after an adjustment don't prove the fix worked.
D5–D6: Select, Validate, and Implement Permanent Corrective Action
Proposed actions must address the verified cause, get tested before full rollout, and update affected documents, control plans, or FMEAs. Each action needs a named owner and due date.
AS13000A sets a 30-day target for D5 completion from problem identification, unless otherwise agreed, according to SAE's AS13000A standard. Implementation should connect to change control, not happen quietly outside it.
D7–D8: Prevent Recurrence, Verify Effectiveness, and Close
D7 pushes the fix wider: updated control plans, training, supplier controls, and a check for similar processes or components that share the same risk. D8 closes the loop with objective evidence that the problem hasn't recurred, plus team recognition and formal records retention. Closing without effectiveness evidence is one of the most common and most damaging shortcuts in aerospace 8D work.

Where AS13000 Is Applied and What Affects Results
AS13000-style responses typically get triggered by:
- Customer complaints or rejected product
- Supplier nonconformities
- Internal or external audit findings
- Field escapes, warranty events, or recurring internal defects
Contracts vary on thresholds, so always check the customer-specific requirement before assuming a given defect rate automatically triggers a formal 8D.
Where it sits in the lifecycle: supplier quality, incoming inspection, manufacturing, special processes, assembly, final inspection, delivery, and post-delivery feedback all generate inputs that may need a structured response.
Records that often need alignment:
- Nonconformance reports and material review decisions
- Inspection results and concessions
- Engineering change records
- Customer portals
- AS9100D corrective-action records and supplier scorecards
What affects outcome quality:
- Inputs: accurate defect data, lot and serial traceability, drawings, and specifications
- Operating conditions: urgency, containment status, and supplier responsiveness
- System dependencies: document control, configuration management, calibration, and FMEA/control-plan linkages
- Scale and recurrence: whether the issue is isolated or has appeared before
- Regulatory constraints: contractual reporting timelines and customer notification requirements (verify these against your own contracts rather than treating any example as universal)
Common Issues and When AS13000 May Not Be Appropriate
A few misconceptions keep causing problems:
- AS13000 is not simply a form to fill out
- 8D without evidence is not a substitute for proof
- Containment is not correction
- A suspected cause is not a verified root cause
- "No recurrence yet" is not the same as demonstrated effectiveness
Execution failures are common and predictable. Teams often:
- Jump straight to a favorite tool before defining the problem
- Assign the issue to one department instead of forming a cross-functional team
- Close actions without effectiveness data
- Forget to update the FMEA and control plan the fix was supposed to touch
Proportionality matters. A full AS13000/8D response fits significant, recurring, systemic, or safety-related problems. A low-risk, isolated issue may only need a simpler documented correction, if customer requirements allow it. Not every nonconformity needs the full D0–D8 machine.
Watch for signals that a different or additional method is actually needed:
- A design-risk issue calling for FMEA or engineering analysis
- A broader management-system issue calling for a formal CAPA
- An immediate safety issue requiring escalation, not a structured investigation timeline
- A supplier performance issue requiring supplier development, not another 8D report
Choosing the right method takes judgment. QMS Learning's Aerospace & Defense Audit-Ready pathway and AI Workbench support that call: the Workbench helps teams diagnose the problem, recommends whether 5-Why, FMEA, CAPA, or a full 8D fits, and generates supporting documentation. It doesn't replace your customer or standard requirements. It helps your team apply them correctly and consistently.

Conclusion
AS13000 gives aerospace suppliers an industry-specific lens for disciplined problem-solving, while 8D supplies the recognizable D0–D8 structure that carries a team from containment to verified prevention. Value comes from applying the method proportionately, proving causes and effectiveness with real evidence, and tying the response back into your AS9100D system rather than treating it as a one-off exercise.
Frequently Asked Questions
What is the purpose of AS13000?
AS13000 supports consistent, structured resolution of aerospace supply-chain problems. It drives containment, verified root-cause analysis, corrective action, prevention of recurrence, and documented communication to the customer.
Is AS13000 the same as 8D?
No. They're closely connected, but not identical. AS13000 defines aerospace customer requirements for using 8D; 8D is the underlying eight-discipline problem-solving method itself.
What are the steps in an AS13000 8D response?
D0 through D8: prepare and contain, form the team, define the problem, implement interim containment, verify root cause, select and implement corrective action, prevent recurrence, verify effectiveness, and close.
Does AS13000 replace AS9100D corrective action?
No. AS13000-style 8D can support and feed evidence into your AS9100D corrective-action process, but it doesn't automatically replace your documented nonconformity, risk, or customer-specific requirements.
When should an aerospace supplier use AS13000?
It fits significant, recurring, systemic, or potentially safety-impacting problems, subject to your specific customer contracts, portals, and internal escalation criteria. Low-risk isolated issues may not need the full process.
What evidence should an AS13000 response contain?
A factual problem statement, containment records, cause-analysis evidence, validated corrective actions, updated documents or control plans, named owners and due dates, and effectiveness results supporting formal closure.
